What the Weston transmission project opposition means for zoning law
market dataSource type: independent reporting

What the Weston transmission project opposition means for zoning law

The Weston City Council and Upshur County Commission have passed resolutions opposing the Valley North transmission project. This article examines what legal weight local zoning objections carry against a PJM-approved interstate line after the Transource v. DeFrank precedent.

Updated

The legal opposition to the Weston-area transmission project is no longer just meeting-room objection. On July 21, 2026, the Weston City Council passed a resolution opposing the Valley North transmission project and warning that the city may pursue “regulatory intervention and appropriate legal action.” Four days earlier, the Upshur County Commission had passed its own opposition resolution. Neither vote blocks the line. Neither vote decides whether the West Virginia Public Service Commission will issue a certificate. But together they show that local governments are trying to enter the record before the formal state siting case begins, while they still have room to shape the issues rather than merely react to an application already filed.[1][2]

Small-town municipal building with transmission towers in the background

That timing matters. The Valley North Project is not a neighborhood distribution upgrade. The developer describes it as a PJM-selected, 765-kV transmission line running about 260 miles through West Virginia, Virginia, and Maryland, with an estimated cost of $3 billion.[3] A project of that scale invites regional reliability language, interstate planning assumptions, and federal preemption arguments. Local governments cannot make those disappear by resolution. What they can do, if they are careful, is preserve objections that a state siting body is still allowed to hear.

The Weston resolution is notable less because it says “no” than because of how it says no. The objections it lists are mostly familiar land-use and siting concerns: property value diminution, electromagnetic field health concerns, possible effects on tourism and agriculture, scenic impacts, and criticism of the project’s public engagement process. It also includes a claimed 5% rate increase, but that figure is described as unverified by the council itself and not independently confirmed. That makes it the weakest factual plank in the resolution, even if it is the easiest one to repeat at a public meeting.[1]

Property, farms, viewsheds, health concerns, and meeting procedures sit closer to the lane where local governments traditionally operate. A claimed regional rate impact belongs somewhere else unless it can be tied to competent evidence and the proper tribunal. That distinction is not academic. After Transource, the difference between a siting objection and a disguised attack on regional need may determine whether an argument gets considered or swept aside.

What Weston and Upshur County have actually done

The two resolutions are pre-application acts. The available record indicates that the Valley North Project has not yet filed a certificate application with the WV PSC or with the Virginia State Corporation Commission. That leaves the Weston and Upshur County resolutions in an in-between posture: politically concrete, legally incomplete, and potentially useful if they are later placed into the correct administrative record.[1][2]

The Upshur County resolution matters because it shows the Weston action was not isolated. It documents a second local government formally opposing the same project, supporting the appearance of a coordinated county-and-municipal front rather than a single council reacting to a single route concern.[2] MetroNews coverage before those votes described local opposition and resident concerns, giving the resolutions a public context: landowners and residents were already worried about how the line could affect homes, farms, and communities before local officials converted that concern into formal action.[4]

Still, a resolution is not a zoning denial, a certificate order, an injunction, or a condemnation ruling. It is a local government’s statement of position. Its value depends on whether it identifies facts the PSC may weigh, whether those facts are supported later, and whether local officials intervene or otherwise participate when the certificate process opens.

Local actionWhat it can do nowWhat it cannot do by itself
Weston City Council resolutionPreserve city-level objections to routing, local impacts, process, and possible interventionVeto a PJM-selected transmission project or decide the WV PSC certificate
Upshur County Commission resolutionShow county-level opposition and support a coordinated local recordBind the PSC or decide property-specific condemnation issues
Grassroots opposition and public commentsIdentify affected landowners, recurring concerns, and route-specific issuesSubstitute for evidence in a formal siting case

That is the first legal sorting exercise. The resolutions are not empty. They are also not self-executing. Treating them as either would miss the point.

Why the category of objection matters after Transource

The Third Circuit’s 2025 Transource decision supplies the frame now hovering over local opposition to PJM-approved projects. In that case, the court held that states cannot use their approval authority to veto a PJM-approved regional transmission project by second-guessing PJM’s determination of regional need. The court treated that kind of state rejection as conflict-preempted. But it also preserved room for traditional state and local siting concerns, including environmental, health, safety, and land-use issues.[5]

The U.S. Supreme Court denied certiorari on June 8, 2026, leaving the Third Circuit decision standing.[6] That does not make Transource binding law in West Virginia. West Virginia sits in the Fourth Circuit, not the Third. A WV PSC party may cite Transource because it is persuasive and directly relevant to PJM-selected transmission lines, but no one should write as though a Pennsylvania federal appellate decision automatically controls a West Virginia siting dispute.

The practical lesson is still hard to ignore. If a local government frames its opposition as “PJM did not need this project,” it walks toward the preemption problem. If it frames opposition as “this route imposes specific land-use, agricultural, health, scenic, and community impacts that the state siting body should weigh,” it stays closer to the space Transource left open.

That is why the Weston wording deserves a close read. The city’s property-value, tourism, agriculture, EMF, scenic, and process objections are not guaranteed winners. Some may need expert support. Some may require affected parcels, route alternatives, or agency findings before they become administratively useful. But they are recognizably siting objections. By contrast, the unverified 5% rate-increase claim is vulnerable because it sounds like a broad economic attack unless someone later supplies a reliable source and explains why the PSC may consider it in the siting certificate context.[1]

The WV PSC proceeding is where the resolutions either gain weight or stay symbolic

West Virginia law supplies the next procedural gate. W.Va. Code §24-2-11c requires a siting certificate for qualifying electric transmission facilities and gives the PSC a 300-day decision window once a completed application is filed.[7] That is the arena where Weston and Upshur County can try to convert local opposition into evidence, route conditions, mitigation requests, or formal party arguments.

The clock has not started if the application has not been filed. For local counsel, that makes the current period unusually important. A pre-application resolution can identify issues early, but it should not be the last document a city or county produces. The useful record will likely need more than a general statement that residents object.

  • Route-specific facts: which corridors, parcels, farms, roads, viewsheds, and community facilities are implicated.
  • Jurisdictional discipline: which objections belong before the PSC, which belong in local land-use records, and which belong elsewhere.
  • Evidentiary support: whether claimed impacts are documented by competent testimony, studies, maps, or affected landowner submissions.
  • Requested relief: whether the local government seeks denial, rerouting, conditions, mitigation, or additional process.

That last point is often where local opposition loses precision. A resolution that says the project is harmful may help show political opposition. A filing that identifies a particular route segment, explains why it conflicts with agricultural operations or local development patterns, and proposes an alternative or condition gives the PSC something more concrete to evaluate.

The same distinction applies to public process complaints. Weston criticized the project’s drop-in meeting format.[1] That complaint will carry more weight if local officials later connect it to a procedural consequence: residents did not receive enough information to understand route options, landowners could not identify whether their property was affected, or the developer failed to respond to specific local concerns. A bare complaint about format may be easy to acknowledge and easy to dismiss. A process objection tied to missing information is harder to treat as mere dissatisfaction.

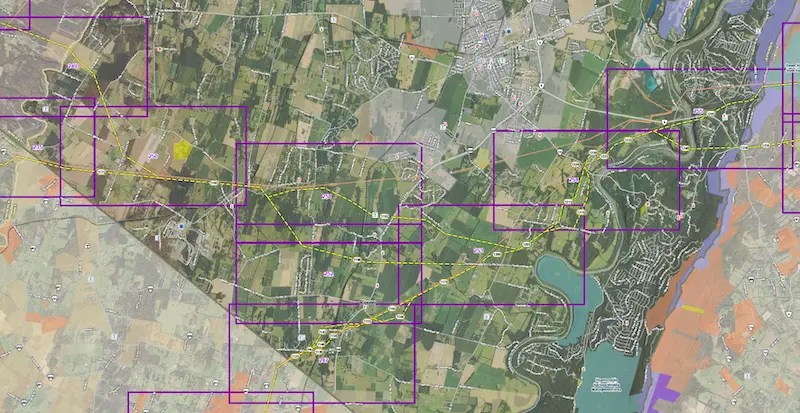

Color-coded Valley North transmission route planning map across Jefferson County, West Virginia

Zoning objections and condemnation fights are not the same case

Transmission opposition often collapses several legal tracks into one public narrative. That is understandable at a town hall and dangerous in a filing. The current Weston and Upshur County activity belongs primarily to the zoning and regulatory track: what the PSC should consider when deciding whether and how to certificate the project. Eminent domain, if it arises later, would involve property-specific condemnation disputes after the project has cleared other legal thresholds.

The distinction matters because different claims mature at different times. A farmer’s concern that a route would fragment agricultural land may be relevant now as a siting objection. A later dispute over compensation, easement scope, or taking procedure would belong in a different posture. Local governments weaken their own record when they treat those tracks as interchangeable.

For the same reason, local zoning language should be used carefully. A city or county may be able to document comprehensive-plan conflicts, land-use incompatibilities, scenic impacts, or infrastructure burdens. But if the argument becomes a claim that local zoning law alone can nullify a PJM-selected interstate transmission project, it invites the developer to answer with preemption rather than facts.

What the broader opposition record suggests, and what it does not

The Niskanen Center’s transmission research is useful here because it lowers the temperature. In its sample of 37 federally permitted transmission projects, 54% faced little to no opposition; among 18 challenged projects, litigation stopped only one.[8] Those numbers do not prove the Valley North Project will be built, and they do not measure the effect of local resolutions before a state commission. They do suggest that post-hoc litigation is rarely the clean knockout blow opponents imagine.

That makes the PSC process more important, not less. Local governments that wait for a courthouse fight may discover that the project’s need, route, and conditions were already shaped elsewhere. Local governments that intervene early still may not stop a project, but they may affect the route, mitigation, public process, or certificate conditions. The available research supports that narrower expectation. It does not support a confident prediction that coordinated resolutions will defeat an interstate transmission line.

The opposition front is also incomplete on the current record. An estimated 15 West Virginia counties may be affected, but not all have passed formal resolutions. Weston and Upshur County therefore show a pattern, not a statewide wall. That is enough to matter procedurally. It is not enough to assume political inevitability.

The test ahead

The strongest version of the Weston and Upshur County strategy is not a broad attack on PJM’s planning judgment. It is a disciplined siting argument: whatever regional need PJM identified, this route and this process impose local costs that West Virginia’s siting authority may consider. That is the legally more plausible route after Transource, even with the important caveat that Transource is persuasive rather than binding in West Virginia.

The weakest version is a resolution record built around unverified numbers and generalized opposition. The 5% rate-increase claim may be politically potent, but without independent support it is not the kind of factual assertion counsel should want carrying the file. The more durable objections are the ones that can be mapped, documented, and translated into PSC-relevant consequences: land fragmentation, route conflicts, scenic impacts, health and safety evidence, property-specific burdens, and procedural gaps.

For now, the legal meaning of the resolutions remains provisional. Weston and Upshur County have not defeated the Valley North Project. They have created a pre-application record and signaled that local governments intend to contest more than public relations. Once a CPCN application is filed, the real measure will be whether those objections alter routing, conditions, mitigation, or the administrative record before any condemnation phase begins.
