SpaceXAI Southaven Turbine Removal Timeline Hinges on Staggered Dates

The July 2026 MDEQ agreed order, not SpaceXAI's own announcement, controls when each group of temporary turbines at the Memphis-area data center must come offline. This record provides a citeable, phased chronology distinguishing binding deadlines from company claims, sourced to the primary order and verified by counsel.

By Editorial TeamUpdated Aug 2, 2026Verified Aug 3, 2026
CONFIRMED
Jurisdiction
US-MS
Court
N.D. Miss.
AI tool named
xAI
Ruling date
Jul 30, 2026
Source document
View primary court order ↗
Last verified
Aug 3, 2026

Lex Machina Review is an independent risk-tracking and reference resource. Nothing on this site is legal advice, and using it does not create an attorney-client relationship. Every record is reviewed against primary sources but may not reflect the most current status of a matter — always verify directly against the cited court order, rule text, or a licensed attorney before relying on it.

Companion explanation — secondary to the source document above

Record status

Last verified: Aug. 3, 2026, 00:00 UTC. Legal-background review: Jordan Lee, J.D. This record is for legal-risk orientation and source verification only; it is not legal advice.

The short answer for the SpaceXAI Southaven data center turbine removal timeline is that it should not be cited as one July 2027 deadline. The operative document is the July 30, 2026 MDEQ agreed order involving MZX Tech (xAI), identified in the source record as order id 1862315; the company’s public update is relevant, but it is not the controlling instrument for the retirement schedule.[1][2][3]

The granular dates below are separated by source status. Where the date comes from the agreed order’s existence and identity, it is treated as order-linked. Where it comes from Mississippi Today’s July 31 reading of the order PDF rather than a directly quoted provision reproduced here, it is marked as reported-until-primary-verified. That distinction matters before anyone turns a timeline note into a filing sentence.

Illustration of temporary gas turbine units being retired in staggered phases at a data-center power site

The retirement schedule to cite

Date or periodWhat the record saysLegal forceSource status
July 30, 2026MDEQ agreed order involving MZX Tech (xAI) entered into the record.Binding regulatory instrument, subject to the order text.Primary order page identified.[1]
As early as August 2026SpaceXAI says temporary turbine retirement will begin as early as August 2026.Company statement; useful for public-position evidence, not the operative schedule.Company update.[3]
Aug. 18, 2026Retirement of temporary turbines reportedly begins under the order schedule.Order-derived deadline if confirmed in the PDF text.Reported-until-primary-verified from Mississippi Today’s reading of order id 1862315.[2]
April 2027A majority of temporary turbines must reportedly be retired by April 2027.Order-derived milestone if confirmed in the PDF text.Reported-until-primary-verified.[2]
Beyond the original 12-month limitMississippi Today reports that 13 units may operate beyond the original 12-month deadline, including three for up to five months longer.Reported order allowance; should not be paraphrased without checking the exact order language.Reported-until-primary-verified.[2]
July 14, 2027The newest units, brought online in July 2026, reportedly must cease operating by this date.Order-derived outside date for that group if confirmed in the PDF text.Reported-until-primary-verified.[2]
July 2027SpaceXAI says all temporary turbines will be removed by July 2027.Company representation; does not replace the staggered order schedule.Company update.[3]

The clean drafting point is narrow: do not write that “the turbines must be removed by July 2027” unless the sentence is only describing SpaceXAI’s public statement. For an order-based chronology, the safer formulation is that retirements reportedly begin Aug. 18, 2026, a majority is reportedly due by April 2027, and the newest July 2026 units reportedly cease by July 14, 2027, with a reported allowance for 13 units to operate beyond the original 12-month limit.[2]

That is not a stylistic preference. It is the difference between citing a regulator’s agreed order and citing a company’s communications page. The company’s “as early as August 2026” language is compatible with the reported Aug. 18 start, but it is less precise. Its “all removed by July 2027” statement is also compatible with the reported July 14 outside date for the newest units, but it hides the interim milestones and the reported exception for certain units.[2][3]

Why the turbine count cannot be left undated

The count problem is the easiest place for a legal note to become unreliable. Public accounts and pleadings describe a fleet that grew over time, so “the turbines” is not a stable inventory unless the date and source travel with the number.

Date or filing pointReported countSource basisUse with caution
August 202518 temporary turbinesDated fleet-growth snapshot in the available reporting record.[2][5]Reported context; attach the underlying dated source before using as a primary count.
April 2026 complaint27 turbines; 495 MW alleged baselineNAACP/SELC/Earthjustice complaint filed in federal court.[4]Allegation in a complaint, not an adjudicated finding.
May 202646 temporary turbinesDated fleet-growth snapshot in the available reporting record.[2][5]Reported context; do not merge with later counts.
June 202660 turbines; 52 operating; 14 with SCRCommercial Appeal report citing email correspondence.[5]Snapshot tied to the correspondence described in that report.
July 202669 temporary turbinesMississippi Today/Kym Meyer reporting tied to the July 2026 order coverage.[2]Current for that report, not a retroactive count for earlier filings.

A brief that says “SpaceXAI operated 69 turbines when the April complaint was filed” would be wrong on the materials available here. The April complaint alleged 27 turbines and 495 MW, while later reporting described a larger fleet by May, June, and July 2026.[4][5][2]

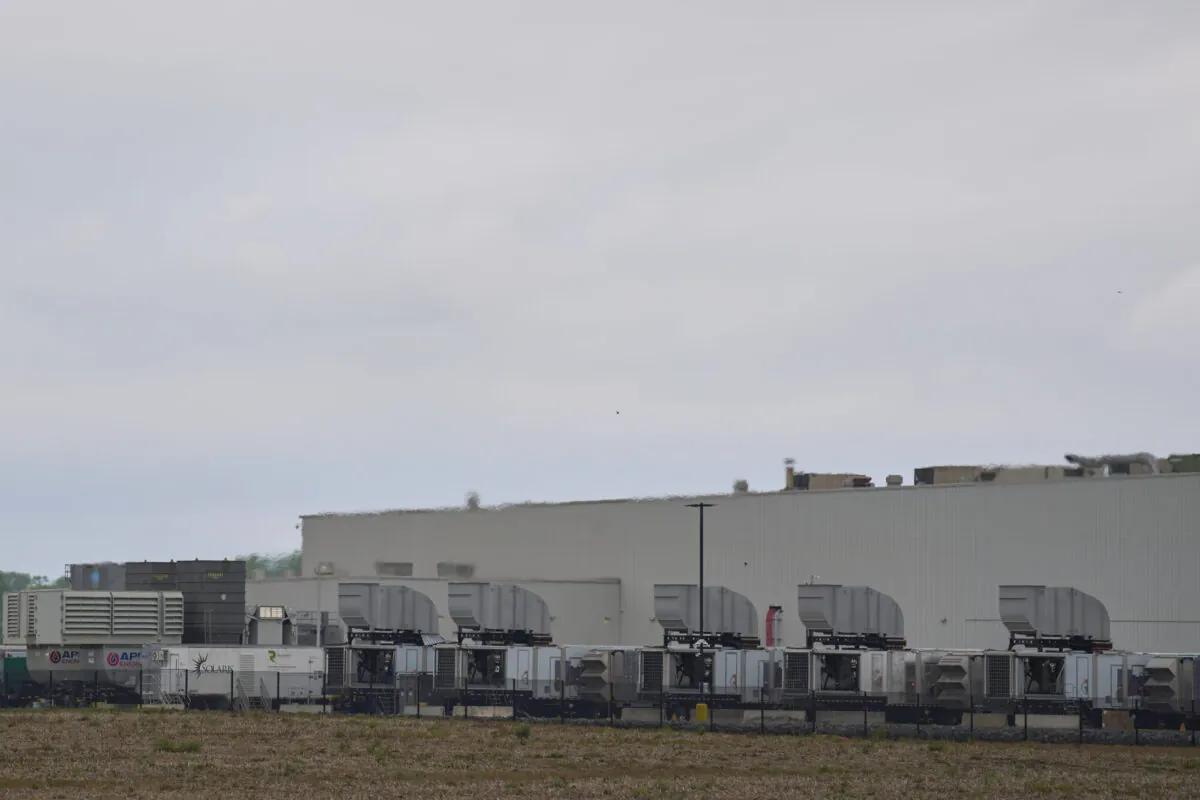

Rows of temporary gas turbines at the SpaceXAI Southaven data center site

The order schedule sits on top of an unresolved dispute

The regulatory history starts before the July 2026 agreed order. On July 29, 2025, MDEQ issued a determination letter on portable gas combustion turbines, which is the relevant exemption-origin document in the available record.[6]

The federal litigation then supplied a different kind of record. The April 2026 complaint by the NAACP, SELC, and Earthjustice alleged that the Southaven operation involved 27 turbines and 495 MW, and it asserted potential Clean Air Act penalties of up to $124,426 per day.[4] Those figures belong to the complaint. They should not be recast as MDEQ findings or as the July 2026 order’s own measurements.

The Department of Justice later intervened in the gas-turbine lawsuit, according to Utility Dive’s June 18, 2026 report.[7] The July 30 agreed order therefore should not be described as ending the federal Clean Air Act dispute. It creates a state regulatory retirement schedule for the temporary units; it does not, on the sources available here, dispose of the federal docket.

A defensible note can separate the three records this way:

  • Order identity: the relevant instrument is the July 30, 2026 MDEQ agreed order involving MZX Tech (xAI), order id 1862315.[1]
  • Reported order schedule: Mississippi Today’s July 31 reading reports retirements beginning Aug. 18, 2026, majority retirement by April 2027, a July 14, 2027 cessation date for the newest July 2026 units, and an allowance for 13 units to run beyond the original 12-month limit, including three for up to five months longer.[2]
  • Company statement: SpaceXAI says retirement may begin as early as August 2026 and that all temporary turbines will be removed by July 2027.[3]
  • Inventory snapshots: turbine counts must be date-stamped because the public record moves from 27 alleged in the April 2026 complaint to later reports of 60 in June and 69 in July 2026.[4][5][2]

If the sentence is going into a partner alert, an executive briefing, or a litigation chronology, the safest wording is not “all turbines are due out by July 2027.” A better version is: “Under the July 30, 2026 MDEQ agreed order, public reporting describes a staggered retirement schedule for SpaceXAI’s temporary Southaven turbines, with retirements beginning Aug. 18, 2026, majority retirement by April 2027, and the newest July 2026 units ceasing by July 14, 2027; SpaceXAI separately states that all temporary turbines will be removed by July 2027.”[1][2][3]

Before filing or relying on the exception language, check the PDF text of order id 1862315 directly. The reported allowance for 13 units, including three for up to five months longer, is exactly the kind of detail that should be quoted from the order rather than inherited from a news paraphrase.[2]

What the supply-chain explanation does, and does not, prove

Mississippi Today reports that the allowance for some units to operate past the original 12-month limit is tied to supply-chain timing for a permanent replacement system: 41 turbines and 1.2 GW under a March 2026 PSD permit.[2] That explanation is useful for understanding why a staggered schedule exists. It does not convert the company’s broad July 2027 representation into the operative legal timetable.

It also does not answer the federal Clean Air Act case. Counsel should keep the state agreed order, the complaint allegations, and the DOJ intervention in separate boxes unless a later court filing or agency document connects them more directly.[4][7]

Bottom line for citation

Anyone citing the SpaceXAI Southaven turbine removal timeline should cite the July 30, 2026 MDEQ agreed order and preserve the staggered dates. SpaceXAI’s “all removed by July 2027” statement belongs in the communications column, not in place of the order schedule.[1][2][3]

References

  1. MDEQ + MZX Tech (xAI) Agreed Order — Earthjustice.
  2. State sets dates to retire temporary xAI turbines — Mississippi Today, July 31, 2026.
  3. Memphis Updates — xAI, July 30, 2026.
  4. xAI Southaven Complaint — N.D. Miss., April 2026.
  5. SpaceXAI Southaven enters agreed order to remove temporary turbines — The Commercial Appeal, July 30, 2026.
  6. MDEQ Determination Letter on Portable Gas Combustion Turbines — MDEQ, July 29, 2025.
  7. DOJ intervenes in xAI data center gas turbine lawsuit — Utility Dive, June 18, 2026.
